SR 94 is an east-west route that begins at I-5 in San Diego County and terminates approximately 65 miles to the east at a junction with I-8.  The westerly portion of SR 94, known as the Martin Luther King Jr. Freeway, begins at the I-5 interchange and ends approximately 12 miles to the east in the community of Rancho San Diego.  This segment serves primarily as a commuter route to and from Downtown San Diego.  SR 94 intersects with the north-south routes: I-5, I-805, SR 15, SR 125 and SR 54.  The SR 94 Carpool/Bus Lanes Project from I-805 and I-5 will provide a critical link for a multi-modal transportation system and provide commuters with transportation options by adding Carpool/Bus Lanes to SR 94 from I-805 to the Downtown San Diego area.  The project will modify interchanges, connectors, and bridge overcrossings in the project corridor.

This project also proposes to:

-Improve traffic operations on SR 94 within the project limits where feasible

-Sustain the SR 94 corridor as a transportation resource for nearby residential and commercial areas

-Protect or enhance the natural and human environment along SR 94 within the project's limits



Public Scoping Meeting

Caltrans conducted a public outreach scoping meeting on Wednesday, January 12, 2011 from 5 p.m. to 8 p.m. at the Sherman Heights Community Center, 2258 Island Avenue, San Diego, CA 92102.  See below notice for more details.

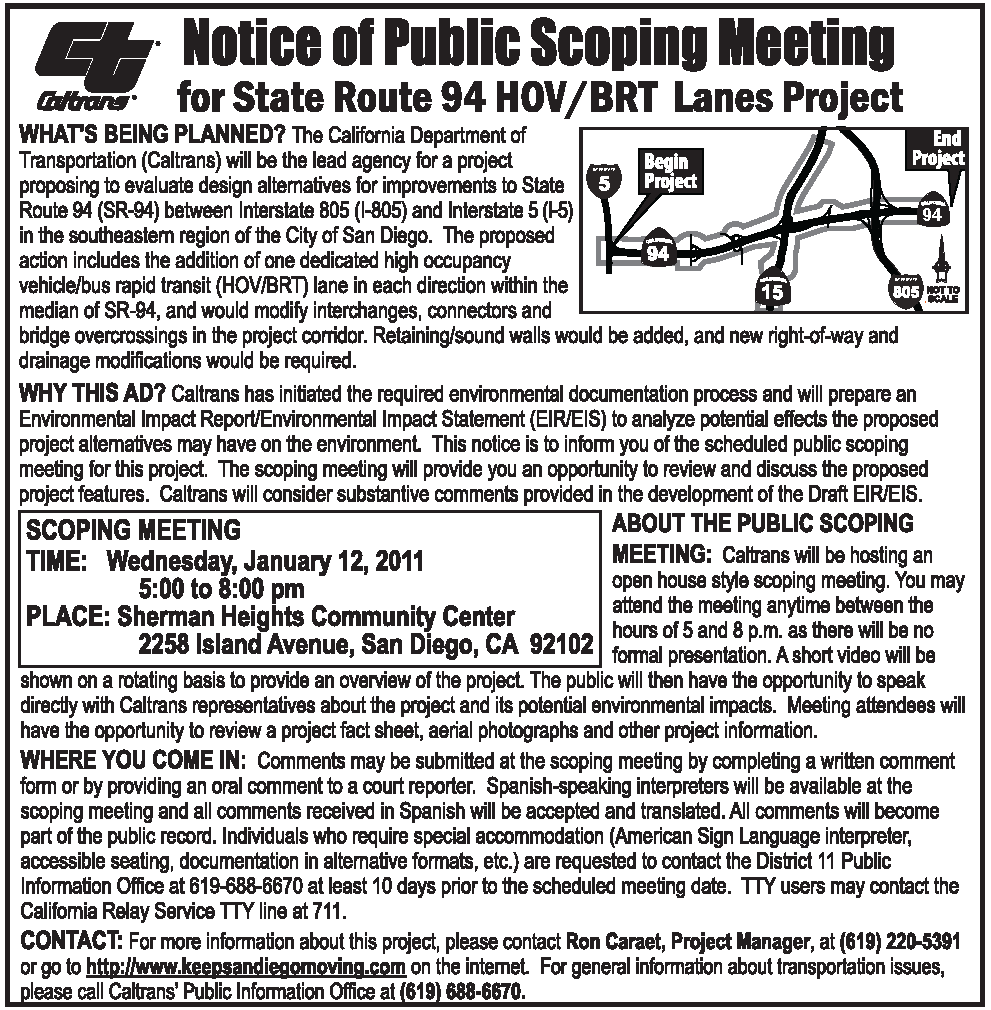

 Public Scoping Meeting Notice

SR 94 Public Scoping Meeting Notice

News Release: Caltrans Seeking Public Opinion on Proposed SR 94 Project (Posted 1/1/11)

Proposed Project Schedule

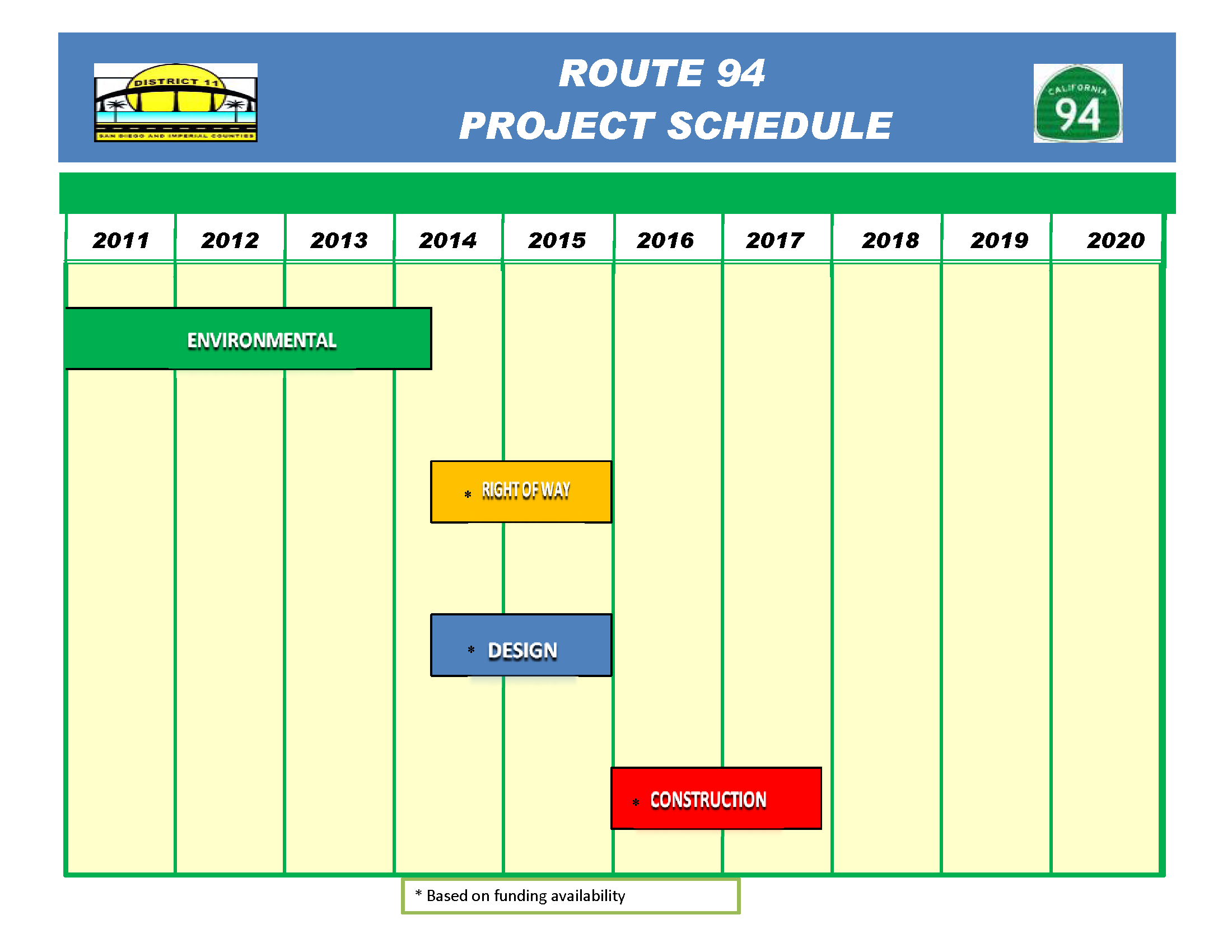

SR 94 Carpool/Bus Lanes Project Schedule



Project Costs

The project cost is estimated at $600 million. Funding for this project comes from Federal, State and Local sources. The environmental work has been funded with $10 million from the State's Traffic Congestion Relief Program and $1 milion from the TransNet regional tax measure.



sandaga
